As many of you have noticed, and as I’ve mentioned from the beginning of my time here (I talked about it in my first homily in July 2024), Holy Family Cathedral needs a new roof. Â The roof was heavily damaged during the Fathers Day Storm of 2023. After much investigation, we determined a simple repair was not possible. Many of you will remember a similar roof project in 2009. The need has arisen again due to severe weather and less than stellar products used on the earlier version. Our new roof will include durable, time proven materials installed by a specialized contractor with a good track record.
Tulsa’s Tri-Spired Gem
Holy Family Cathedral is Tulsa’s “Tri-Spired Gem,” according to Father John Heiring, the pastor who oversaw the construction of the church in 1914.
The three spires are an iconic part of downtown Tulsa’s skyline.
The cross fell of one of the spires, leaving a hole for water to enter the building when it rains.
Â
Â
The Father’s Day storm of 2023
The Father’s Day storm of 2023 dealt significant damage to the three spires and the lower roof. Cathedral Rector Father Brian O’Brien and the church’s finance council have chosen Executive Exteriors to begin repairs.
Dozens of shingles have fallen and continue to fall from the spires.
Budget
Total Project Budget
$3,291,969
Insurance Payment
$1,200,000
Budget Shortfall
$2,091,969
Repairing the Roof FAQ: prepared by Operations Manager Monica Conro
Holy Family Cathedral was built in 1914. The best information we have indicates the majority of the original roof was covered in slate tiles, a small sample of which still exists on the rectory. The peak of each spire is clad in the original copper. Complete roof replacement has been necessary several times in the Cathedral’s history, most recently in 2009 at a cost of $1M. In that renovation project, the primary concern were the internal structure of the spires which were constructed the original wood framing. In serious disrepair due to wood rot, Holy Family was in danger of being condemned by the City of Tulsa. Two thirds of the internal structure of the spires was rebuilt with steel leaving the top third with the original internal wood structure and an external roofing system of original copper plating.

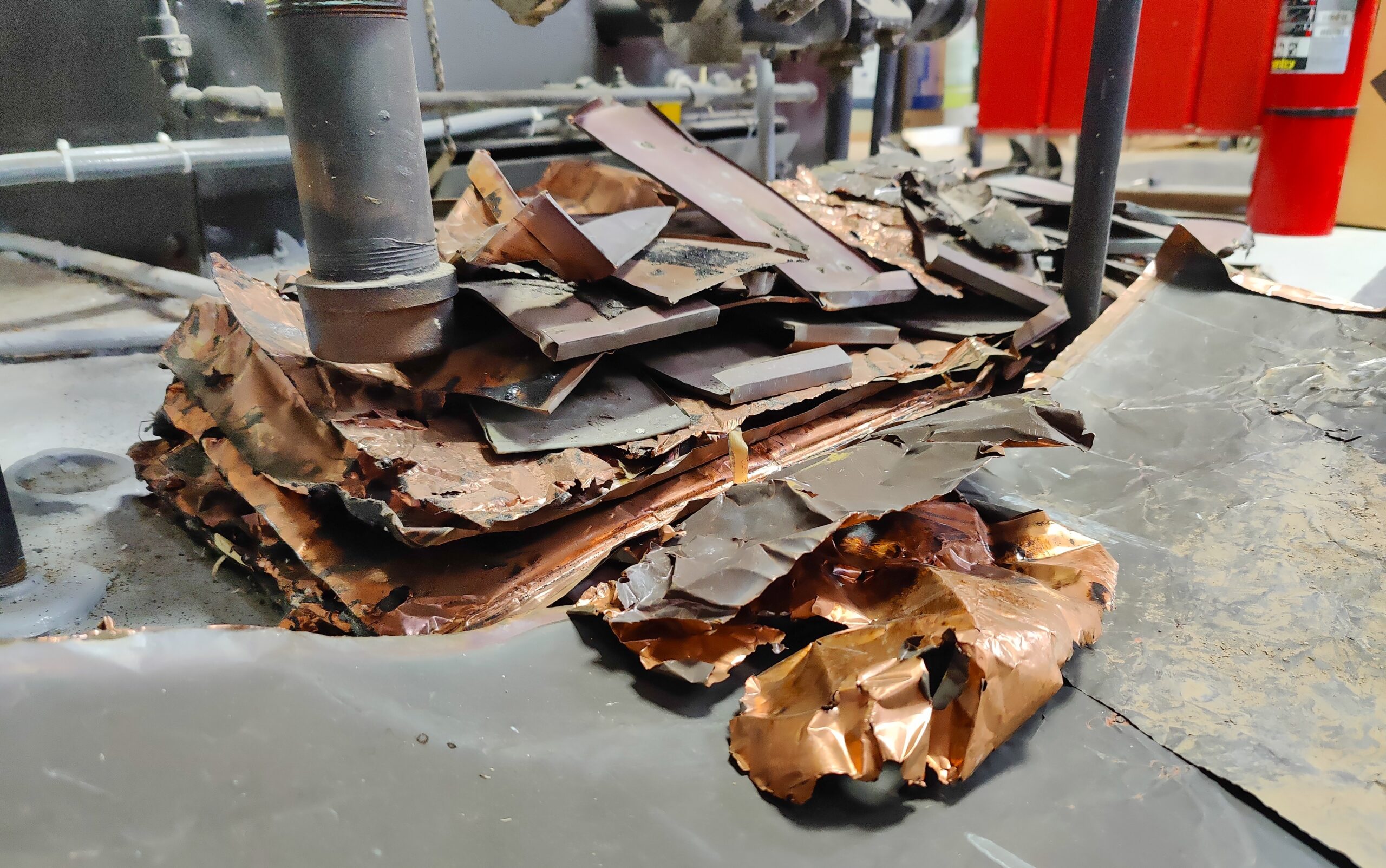

The Father’s Day storm of 2023 left the Cathedral roof with significant damage. In an effort to determine the extent of the damage, drones were flown above the roof and inside the spires and attic spaces. Footage revealed broken windows, disfigured copper features, roof system failure, water damage, and compromised wood structural supports. In consultation with roofing and construction experts, the most prudent course of action for the health of the Cathedral and to ensure the best defense against Oklahoma storms requires total roof replacement including internal repairs to the spires, replacement of the original copper on the peaks, copper dormers, windows, and lower roof system.
The current roof is covered with a product new to the market in 2009 compromised of an asphalt shingle wrapped in a thin sheet of copper. The product has not been in production for many years and the manufacturer is no longer in business.
Due to the magnitude of the project and technical knowledge required, the Cathedral’s Finance Council approved the hiring of Cooper Project Advisors to assist with the vetting of contractors, reviewing of proposals, and acting as the Owner’s Representative in all aspects of the process.
The Cathedral received proposals from four companies. After comparing pricing, work plans, safety plans, and the firms’ overall experience with complex copper roofing projects, the Cathedral selected Executive Exteriors.
Erection of scaffolding will take about one month. Construction is expected to last six months.
The Cathedral is financially solvent with current monthly collections covering expenses.
The parish is debt free and continues to receive pledges and donations from Elevate, a recent capital campaign. These donations will be used for future facility improvements.
The church’s insurance company released an initial payment last spring to cover part of the roofing costs. Held in the diocesan investment fund, it is currently valued at $1.16M. This is an unnegotiated insurance payout. Executive Exteriors will be assisting Deacon Garlick in negotiating a substantial insurance settlement.
